Gordon Lake Group Remediation Project

Learn about the Gordon Lake Group Remediation Project, the work done to date and what's ahead.

On this page

Overview

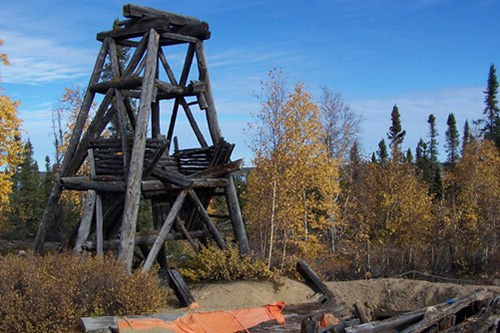

An old headframe made of wood stands above an open shaft surrounded by trees.
This old headframe was on Burnt Island, 1 of the sites included in the Gordon Lake Group project. It was demolished during remediation in 2017. The open mine shaft it stood above was sealed and covered.

Gordon Lake is 110 km northwest of Yellowknife. The Gordon Lake Group Remediation Project cleaned up the following sites:

These sites were part of a single remedial action plan because of how close they are to each other.

The largest mine was Camlaren. Mining activity for gold and tungsten began in this area in the 1940s and continued into the 1990s. 64,137 tonnes of ore were extracted and processed on site, yielding more than 36,000 ounces of gold.

The area is frequently used for hunting, trapping and other land-based activities.

Project goals

Map of the 9 project sites

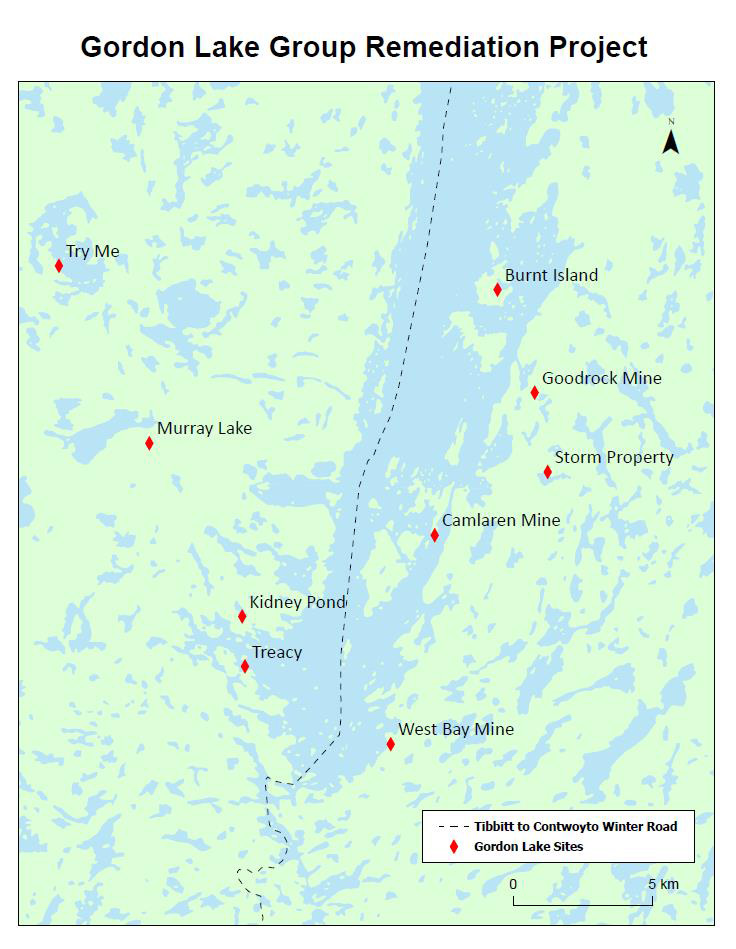

The Gordon Lake Group Remediation Project map shows the 9 project sites, marked by a red diamond. Shown from west to east (left to right): Try Me, Murray Lake, Kidney Pond, Treacy, West Bay Mine, Camlaren Mine, Burnt Island, Goodrock Mine and Storm Property. The map also shows the Tibbitt to Contwoyto Winter Road as a gray broken line, appearing north to south (top to bottom).

The Gordon Lake Group Remediation Project goals include:

Issues at the site

Even though industry cleaned up some of the Gordon Lake sites in the late 1980s, concerns remained. These included:

As a result, prospector's cabins and exploration camps were added to the assessment of the 9 sites. The historical significance to mining heritage was also talked about with:

The full scope of the work needed is outlined in the Remedial Action Plan. For a copy of the plan, visit:

Engagement approach

Crown-Indigenous Relations and Northern Affairs Canada (CIRNAC) is committed to engaging with local communities to provide information about remediation processes. To meet that goal, we meet with Indigenous rights holders and stakeholders regularly to provide site updates.

Site tours

Site tours took place every summer since 2015. Indigenous rights holders and stakeholders were brought to the site to:

  • see the remediation progress in action
  • give input and share their insight

Community update meetings

Since remediation started in 2017, community update meetings also took place every year.

In 2019, the project team led a workshop to develop a framework to build a community-based monitoring program.

Archeological and Traditional Knowledge studies

Before remediation, archeological and Traditional Knowledge studies were carried out in the area. Consultations took place with:

  • the Yellowknife Historical Society
  • the Prince of Wales Northern Heritage Centre

Studies were also done in consultation with the Yellowknives Dene First Nation. They included recording items and areas of cultural or heritage significance.

Learn more: Community Engagement Plan for the Gordon Lake Group Remediation Project (PDF).

Work done to date

2020

The remediation project is in year 2 of long-term monitoring. The goal of long-term monitoring is to make sure the contaminants have been cleaned up and no longer affect:

  • the land
  • air
  • water
  • birds
  • fish
  • wildlife

Monitoring is carried out every year in the spring and fall. It includes:

  • surface water sampling
  • monitoring the tailings and soil containment area (TSCA)
  • visual monitoring

These measures help make sure remedial actions are still in place and effective.

2017 to 2019

Remediation began in summer 2017 and was finished in 2018. Remediation activities included:

  • removing buildings
  • sealing mine openings
  • consolidating and isolating contaminated soils, tailings and waste rock
  • building a tailings and soil containment area (TSCA) at Camlaren
  • revegetating soil

Equipment was demobilized (removed from site) in early 2019 through a winter road.

Phase 1 of long-term monitoring began in the summer of 2019. The goal of phase 1 was to make sure the site didn't pose a threat to the environment.

2016

The remediation contract was awarded to a joint venture between:

  • Delta Engineering Ltd.
  • Nahanni Construction Ltd.

The Mackenzie Valley Land and Water Board awarded the Land Use Permit and Water Licence for the remediation work.

The remedial action plan for the group of sites was developed based on talks with:

  • First Nations
  • stakeholders

2013 to 2015

Supplemental assessment activities in support of a risk assessment were carried out at the sites to help define risks to:

  • human health
  • the environment

2012

Work on the sites helped to:

  • check if there are contaminants on the site and how much
  • give remedial options
  • estimate clean-up costs

Phase 3 environmental site assessments were completed at:

  • Camlaren Mine
  • Burnt Island
  • West Bay-Blackridge Mine
  • Goodrock Mine
  • Kidney Pond
  • Treacy Mine

Phase 1 and 2 environmental site assessments were completed at:

  • Try Me
  • Murray Lake

2009

Phase 2 environmental site assessments were completed at:

  • Camlaren
  • Burnt Island
  • Kidney Pond
  • West Bay-Blackridge
  • Storm
  • Goodrock
  • Treacy Mine

What's next

Phase 1 of long-term monitoring began in 2019 and will continue until 2023.

Phase 1 includes annual water sampling and visual inspections. These activities will confirm if the selected remedial and risk management measures applied during the remediation program are still protecting human health and the environment at the Gordon Lake Group Remediation Project sites.
